Cloud Migration Without Downtime: Strategies, Costs, and a Practical Plan

TL;DR

  • Migration type depends on how much you change the app, not just where it runs. AWS’s 6 R’s range from rehost (lift-and-shift, no code changes) to refactor (full cloud-native rebuild), plus retire and retain for apps that shouldn’t move.
  • Cost hides in three places: the skipped assessment phase (understanding dependencies is the top migration barrier — 54% of orgs, Flexera 2026), the dual-running window where infrastructure cost roughly doubles, and post-migration waste (29% of cloud spend wasted in 2026, Flexera).
  • Near-zero downtime is real, not a big-bang switch. Run old and new in parallel, keep them in sync with database replication, and cut traffic over gradually — AWS documents blue/green switchover downtime as typically under one minute.
  • The biggest risks are organizational, not technical: skills gaps, unclear ownership, and a rushed discovery phase cause more failures than the tooling does.
  • Execution discipline beats strategy choice. A phased cutover with an open rollback path is what actually prevents downtime and overruns.

Cloud migration is no longer a one-time infrastructure project. As of 2026, 73% of organizations run hybrid cloud estates and treat migration as an ongoing process rather than an event with a finish date.

There is a tension built into this. Migration promises lower costs and more agility, but a poorly planned cutover turns into downtime, data loss, and budget overruns. Tellingly, wasted cloud spend is rising, not falling: as of 2026, 29% of cloud infrastructure spend goes to waste — the first increase in five years.

This article covers three things: the main types of cloud migration and when to use each, what actually drives cloud migration cost, and how to plan a cutover that doesn’t take the business offline.

What Are the Different Types of Cloud Migration?

The type of migration you choose depends on how much you change the application, not just where it runs — from a straight lift-and-shift to a full cloud-native rebuild.

AWS formalized this into a framework known as the 6 R’s. Rehost (“lift-and-shift”) moves an app with no code changes. Replatform (“lift-tinker-and-shift”) moves it with minor tweaks to use managed services. Repurchase replaces the app with a SaaS product. Refactor / re-architect rebuilds it cloud-native. And two strategies exist for what shouldn’t move: retire (decommission) and retain (leave in place).

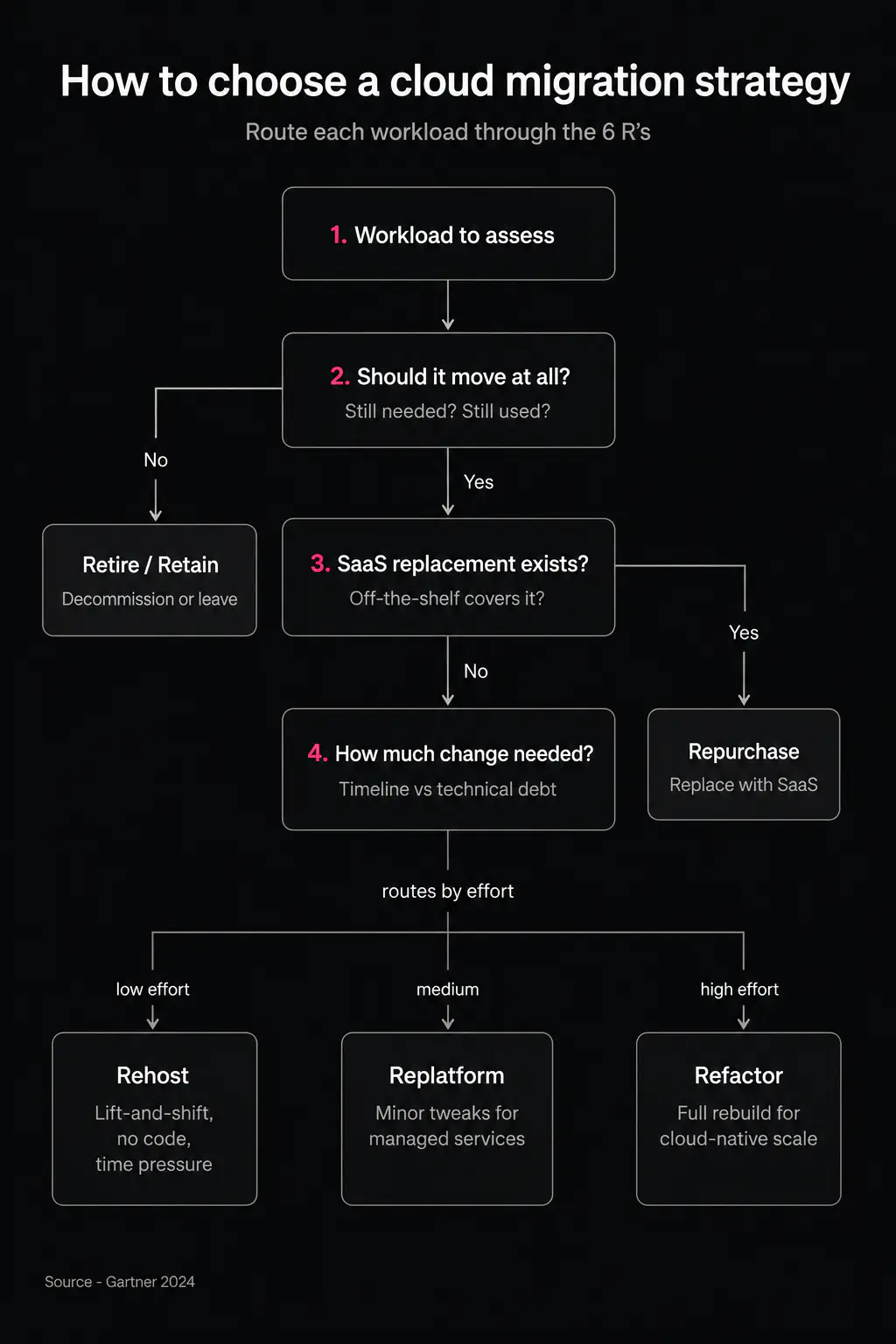

How to choose a cloud migration strategy

Choosing a cloud migration strategy is a decision about effort versus payoff, not a technical preference. Rehost is fast but leaves cloud advantages on the table. Refactor unlocks scale but costs the most and takes the longest. This is also where application migration to cloud gets planned per workload rather than as one blanket move.

The 6 R’s migration strategies

Strategy

Effort & Time

Code Changes

Best Fit

Rehost (lift-and-shift)

Low

None

Legacy apps under time pressure

Replatform

Medium

Minor

Apps that benefit from managed services

Repurchase

Low–Medium

None

Apps replaceable with SaaS

Refactor / Re-architect

High

Full rewrite

Apps needing cloud-native scale

Retire / Retain

None

N/A

Apps that shouldn't move at all

How Much Does Cloud Migration Cost?

Cloud migration cost is shaped by a few drivers, and the biggest surprises hide where teams don’t look for them.

The most expensive mistake starts before the first workload moves — at assessment and planning. Auditing the existing app portfolio, its dependencies, and data volume is the step most often skipped, and skipping it is the single biggest cause of underestimated budgets. Flexera’s data backs this: understanding application dependencies is the top migration barrier, cited by 54% of organizations. Practitioners describe the same pain more concretely: automated discovery scans miss undocumented connections, and an app breaks in production over a hard-coded IP to an on-prem database that “wasn’t on the diagram”.

The second driver is migration execution and dual-running. During cutover, the old and new environments run in parallel for a window, and infrastructure cost roughly doubles for that period. Teams that don’t budget for this window get surprised mid-project. Sizing it correctly is a core part of any realistic cloud migration plan.

The third is post-migration waste. Cloud doesn’t stop being a line item once the migration is done. As of 2026, an estimated 29% of cloud infrastructure spend goes to waste on oversized instances and unused resources. Without optimization discipline, the savings that justified the migration erode quickly.

For SMBs weighing the numbers, our cloud cost comparison for SMBs breaks the trade-offs down further.

Cloud provider comparison

Provider

Position (Flexera, 2026 State of the Cloud)

Typical Use Case

AWS

83% enterprise usage

Broadest service catalog

Azure

79% enterprise usage

Enterprise / Microsoft-stack shops

Google Cloud

Distant third

Data / AI-heavy workloads

DigitalOcean

Niche (not ranked)

Startups / SMBs

What Does a Cloud Migration Process Look Like Step by Step?

The cloud migration process breaks into three sequential phases, and order matters more than speed here.

Discovery and assessment. First, inventory applications and map dependencies. Classify each workload by criticality and technical debt, and only then assign it a strategy from the 6 R’s. Skip this step and you are planning blind.

Pilot migration. Next, move one low-risk workload to validate tooling, timelines, and rollback steps before committing the full portfolio. If the in-house team lacks cloud-native experience, this is the point to bring in an IT infrastructure outsourcing partner rather than learning on production.

Migration in waves and cutover. Group the remaining applications into waves ordered by dependency and risk, then execute cutover during the lowest-traffic window. Waves give you what a big-bang switch can’t: each group is validated on its own, and a problem rolls back one batch instead of the whole project. Teams running a SaaS product will recognize this pattern from SaaS architecture decisions, where the same wave-and-validate discipline applies.

Is your old architecture blocking your migration?

Spend 2 weeks with Anadea to get a clear technical roadmap and accurate pricing before you scale.
Talk to our team

How Do You Migrate to the Cloud Without Downtime?

Near-zero downtime comes from running the old and new environments in parallel and cutting over gradually, not from a single big-bang switch. This is what a zero downtime migration actually looks like in practice.

The mechanics rest on a few techniques. Blue-green deployment keeps two identical environments: “blue” (current) serves traffic while “green” (new) is prepared and tested. Database replication keeps both in sync — changes from the live database flow continuously to the new one, so data doesn’t diverge at the moment of the switch. Cutover happens gradually, through DNS or a traffic balancer, not a hard flip. And a fast rollback path stays open the whole time: if green fails, traffic returns to blue in seconds.

How short a downtime this delivers in practice is clear from AWS’s own documentation: during a blue/green switchover, downtime is typically under one minute, and the switchover window can be bounded by a timeout starting at 30 seconds (AWS RDS Blue/Green Deployments). The key condition is keeping replica lag near zero before switching; if the new environment hasn’t caught up, the switchover shouldn’t start.

Cutover approach comparison

Approach

Downtime

Rollback Speed

Relative Cost

Big-bang cutover

Hours

Slow

Lowest

Phased / wave migration

Minutes per wave

Moderate

Medium

Blue-green with replication

Near-zero (<1 min switchover)

Seconds via traffic switch

Highest during cutover window

What Are the Most Common Cloud Migration Risks — and How Do You Avoid Them?

Migration risks are rarely purely technical, and the most expensive ones are organizational. A few cloud migration best practices address each.

Data loss and integrity issues. Mitigate with full backups and validation checkpoints before every cutover step, not just at the end. Check integrity only after a full move, and you discover the divergence when rolling it back is already expensive.

Security misconfiguration. Cloud environments default to a different security model than on-prem, and misconfigured storage and access controls are a leading cause of post-migration incidents. Practitioners describe this as the flip side of speed: a team “moved fast and overlooked some fundamental security configurations,” which turned into stressful emergency remediation (real case, 2025). Cloud migration security is a requirement for every wave, not a final step.

Vendor lock-in. Repurchase and refactor strategies tie the business tightly to one provider’s tooling. That isn’t always wrong, but the rigidity is worth weighing deliberately against the flexibility that rehost and replatform preserve.

Underestimating organizational readiness. Migrations fail from skills gaps and unclear ownership as often as from technical issues. When the in-house team lacks cloud-native experience, bringing in a specialist partner is cheaper than paying for the education in production incidents.

Choosing the right cloud migration tools for discovery, replication, and monitoring supports all four — but tools don’t replace the disciplined sequence above.

Conclusion

The right strategy and a realistic budget both matter, but the phased cutover is what actually keeps the business online and the budget intact. Choose a strategy per workload, plan for the dual-running window and the optimization that follows, and move in waves with a rollback path kept open. The technology for near-zero downtime already exists, so the outcome comes down to execution discipline. If you’re weighing a move to the cloud and want a clear read on which workloads to migrate first and how to cut over safely, get in touch with our team — we’ll map it out with you before you commit to anything bigger.

Have questions?

Cloud migration is the process of moving applications and data to the cloud. Cloud migration services are the packaged help around that process — assessment, dependency mapping, execution, and cutover — delivered by an internal team or an external partner. You can run a migration without services; the services exist to reduce the risk of the parts that most often go wrong.
It depends far more on the strategy than on the size of the estate. A rehost of a simple app can take days; a full refactor of a business-critical system runs into months. The variable that most often blows up timelines is discovery — understanding application dependencies is the top migration barrier, cited by 54% of organizations, so a thorough assessment up front is what keeps the schedule honest.
There is no single best cloud migration strategy — the right choice is made per workload, not for the whole portfolio at once. Use the 6 R’s: rehost for speed under time pressure, replatform to pick up managed services, repurchase where a SaaS product already does the job, and refactor only where cloud-native scale justifies the cost. Some workloads should retire or retain instead of moving.
Near-zero, yes. A true zero downtime migration runs the old and new environments in parallel, keeps them in sync with database replication, and switches traffic gradually. AWS documents blue/green switchover downtime as typically under one minute, provided replica lag is near zero before the switch.
As often as not, the cause is organizational rather than technical — skills gaps, unclear ownership, and a skipped discovery phase. Cloud migration security gaps and undocumented dependencies surface after cutover precisely because the up-front assessment was rushed. Migrations that budget properly for assessment and bring in cloud-native experience early tend to be the ones that land on time.

Don't want to miss anything?

Subscribe and get stories like these right into your inbox.

Keep reading

Contact us

Let's explore how our expertise can help you achieve your goals! Drop us a line, and we'll get back to you shortly.
